Built Work / Henry Vilas Garage ADU
Finished ADU interior above garage Vilas Neighborhood, Madison WI — open plan living and kitchen area
Garage ADU All Projects

Two-Story Garage ADU Vilas Neighborhood

700 sq ft ADU Size
5 months Start to CO
On budget Cost Outcome
46×24′ Build Footprint
Madison, WI Location
The Starting Point

Garage space and rental income. A specific goal on a constrained lot.

The clients came in with a clear objective: add garage space to a property that had none, and build a rental unit above it to generate long-term income. Straightforward concept. Real site complexity.

They were being thorough. Proposals out to multiple builders, comparing pricing before committing. We understand that — it’s the right move on a project of this scale. Our process delivered concrete, detailed pricing within a day of the initial consultation.

Then they waited on the other builders.

“If getting a number took two months and still produced a wide range with no structure behind it — the project itself would be no different.”

Over the following two months, one builder in particular went quiet. Follow-ups. Delays. No real numbers. When a figure finally came back, it was a wide cost range without guarantees or confidence behind it. High on price. Low on clarity.

The clients recognized what that experience was telling them and moved forward with Boundless Tiny Homes.

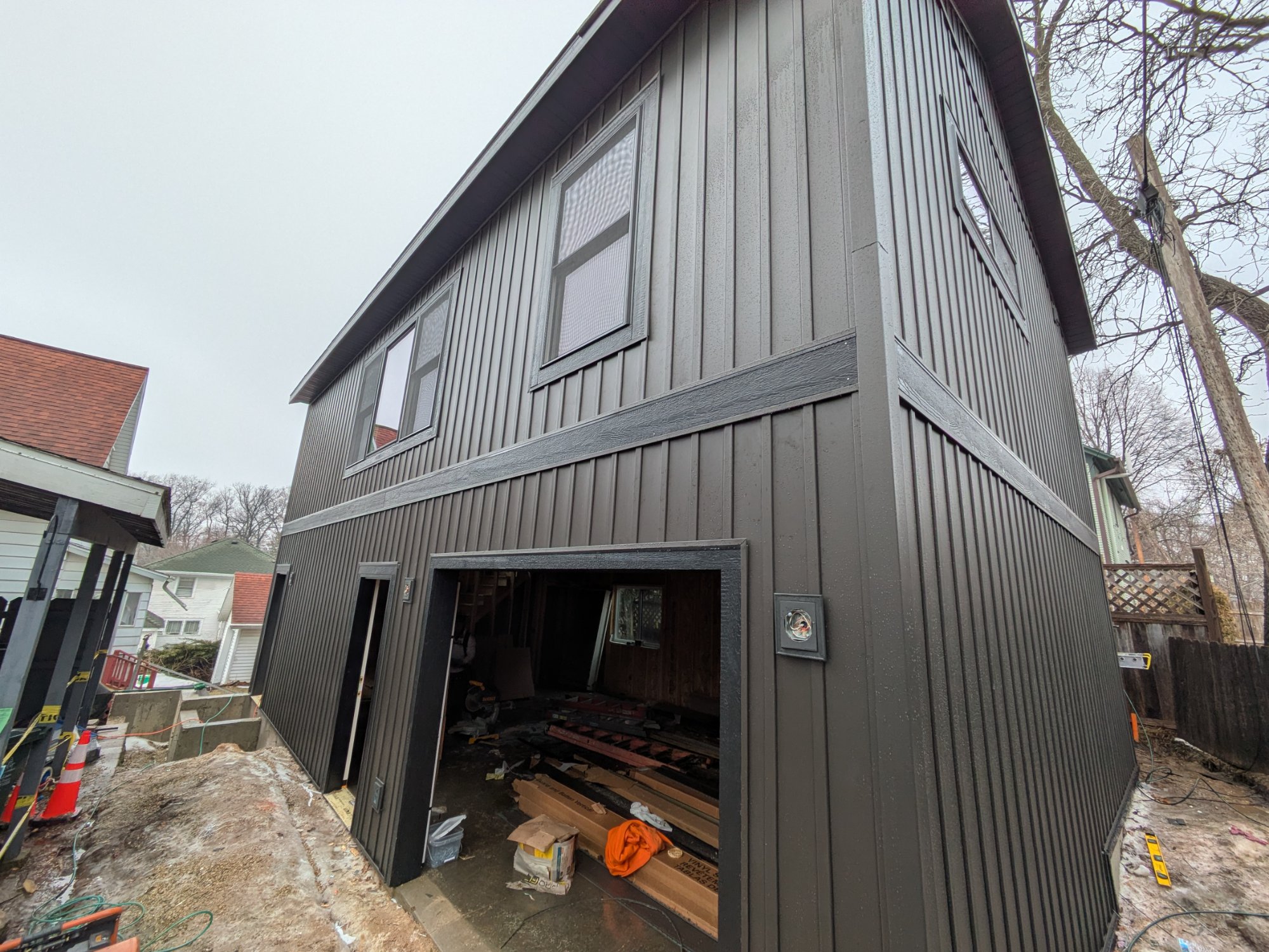

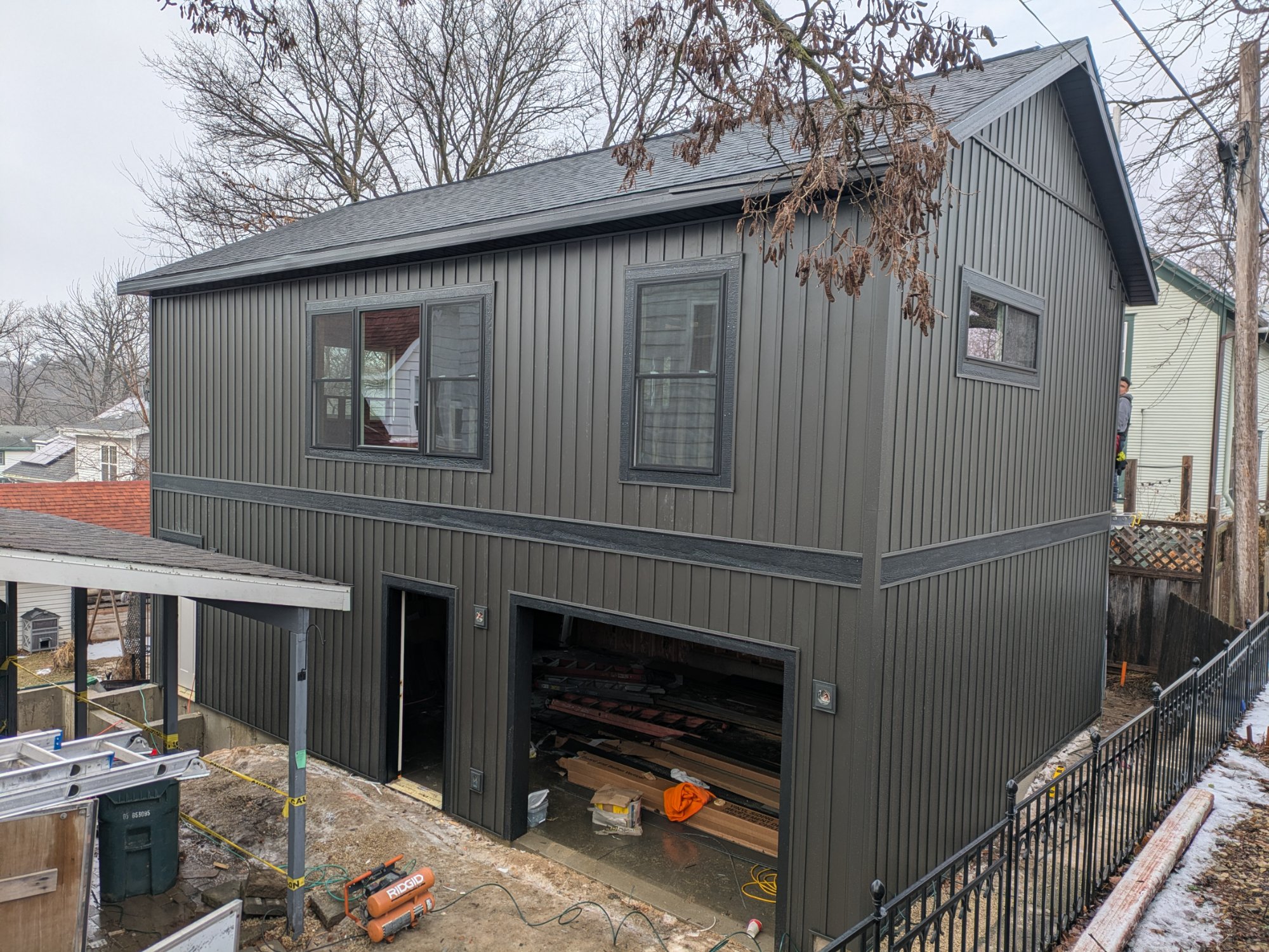

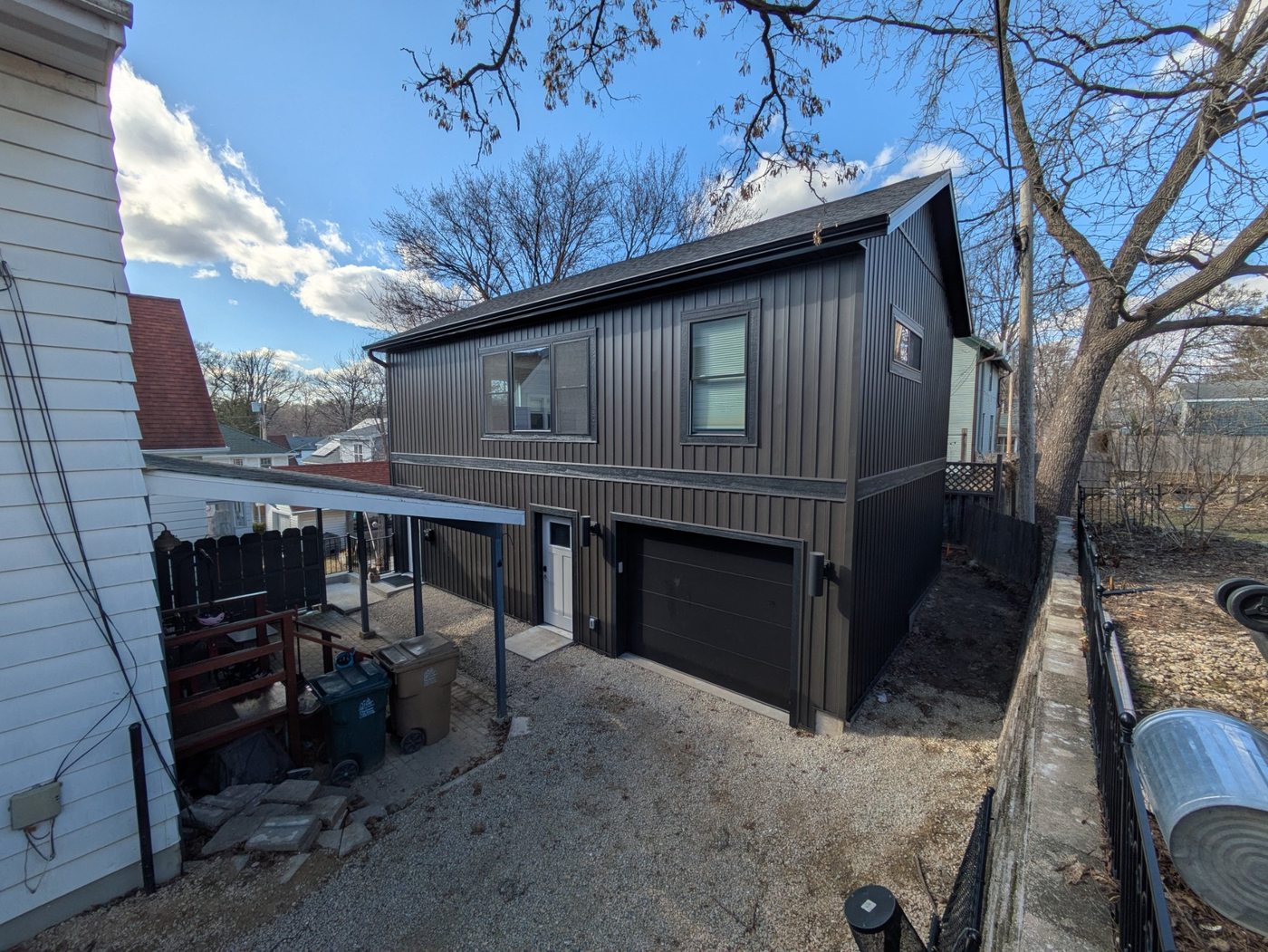

Two-story garage ADU exterior — dark board and batten siding, Vilas Neighborhood Madison WI

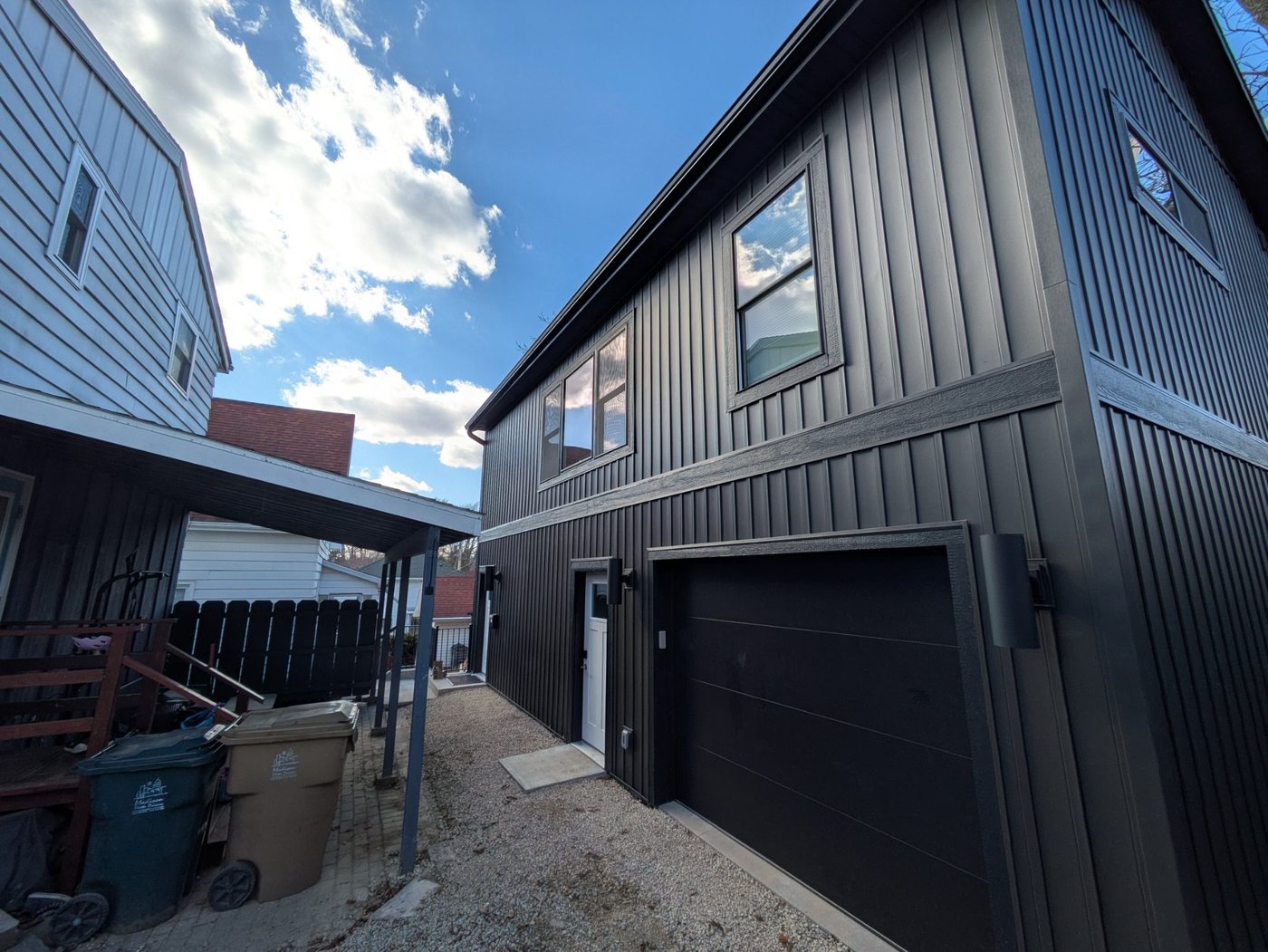

Finished exterior — front elevation with garage bay and ADU entry
Side view of finished two-story garage ADU — board and batten siding, Madison WI
Side elevation — upper ADU windows with living area and bedroom

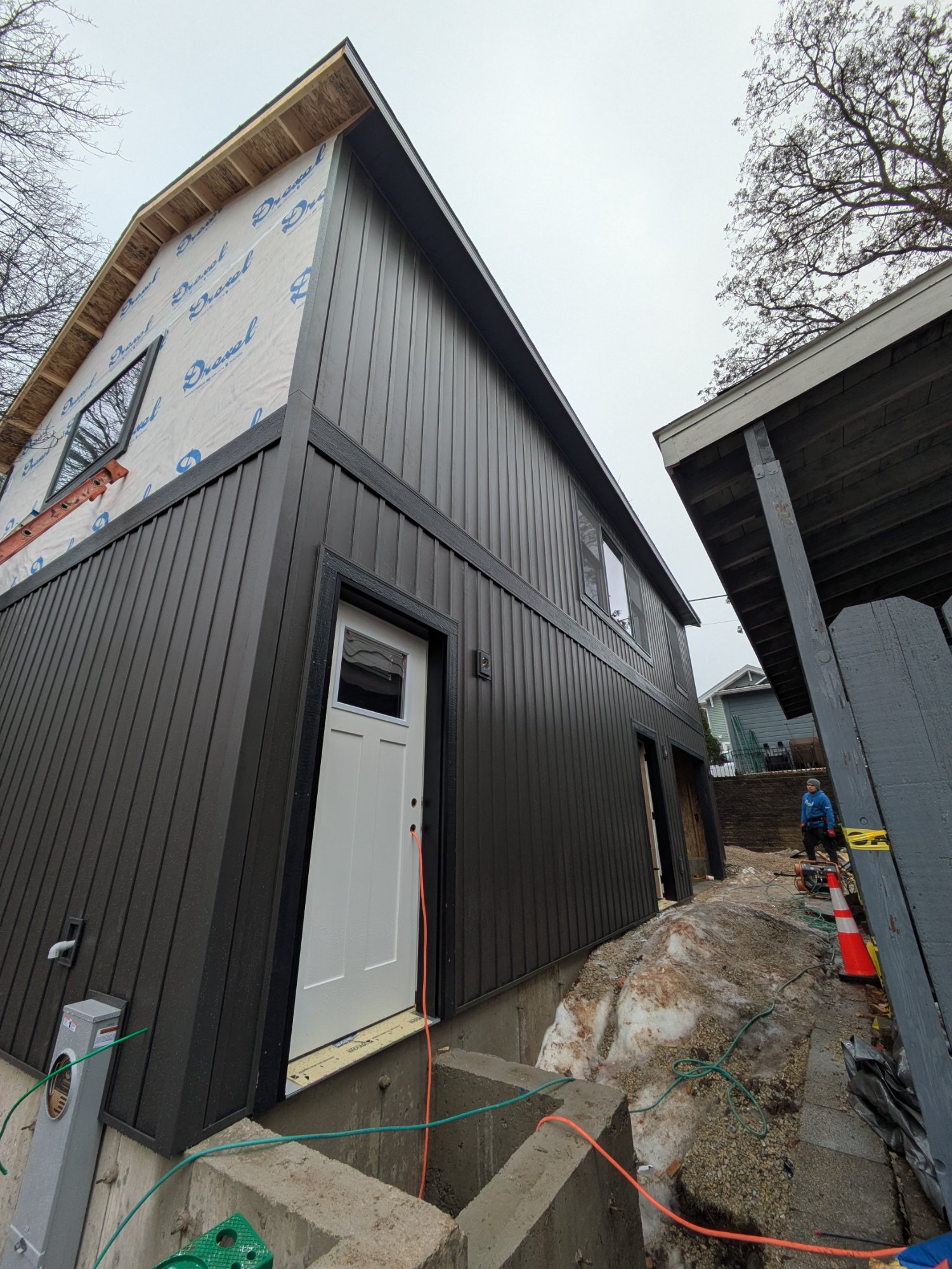

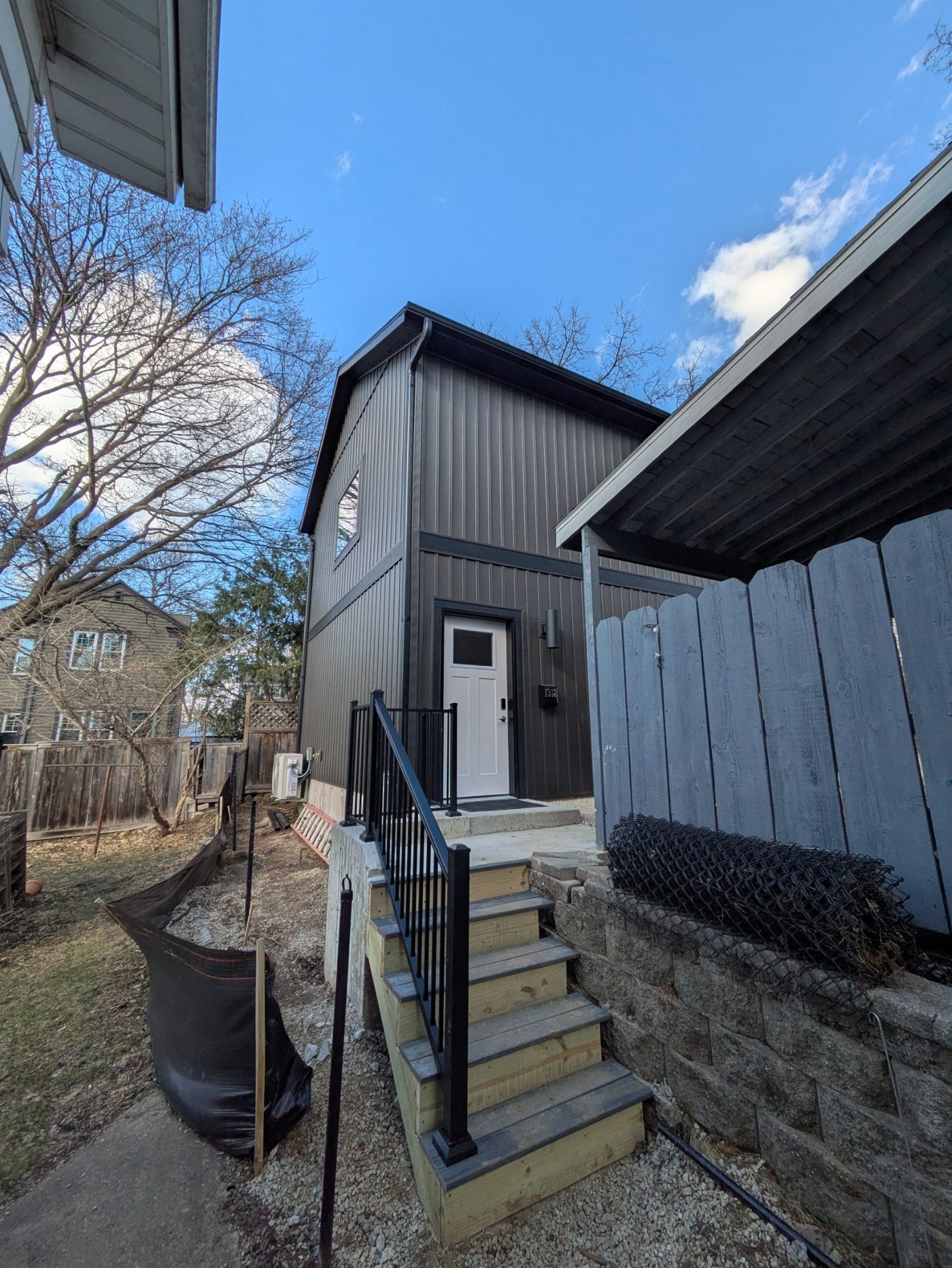

Tenant entry door at grade level with new retaining wall and concrete steps — Henry Vilas ADU Madison WI
Tenant entry — grade-level door with integrated stair access along the retaining wall

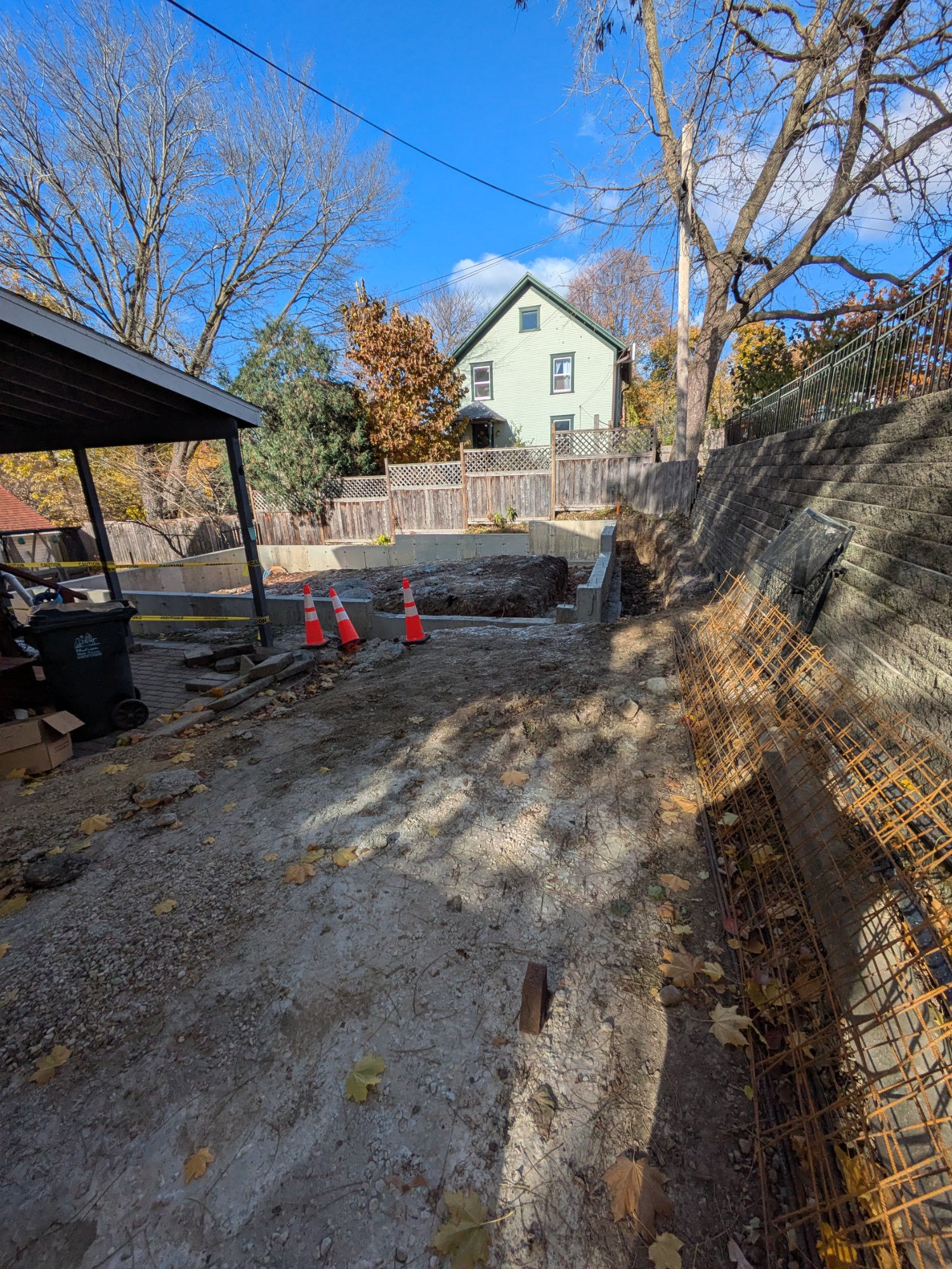

Site excavation with retaining wall rebar in place — Henry Vilas ADU, Madison WI
Excavation and retaining wall prep — fall 2025

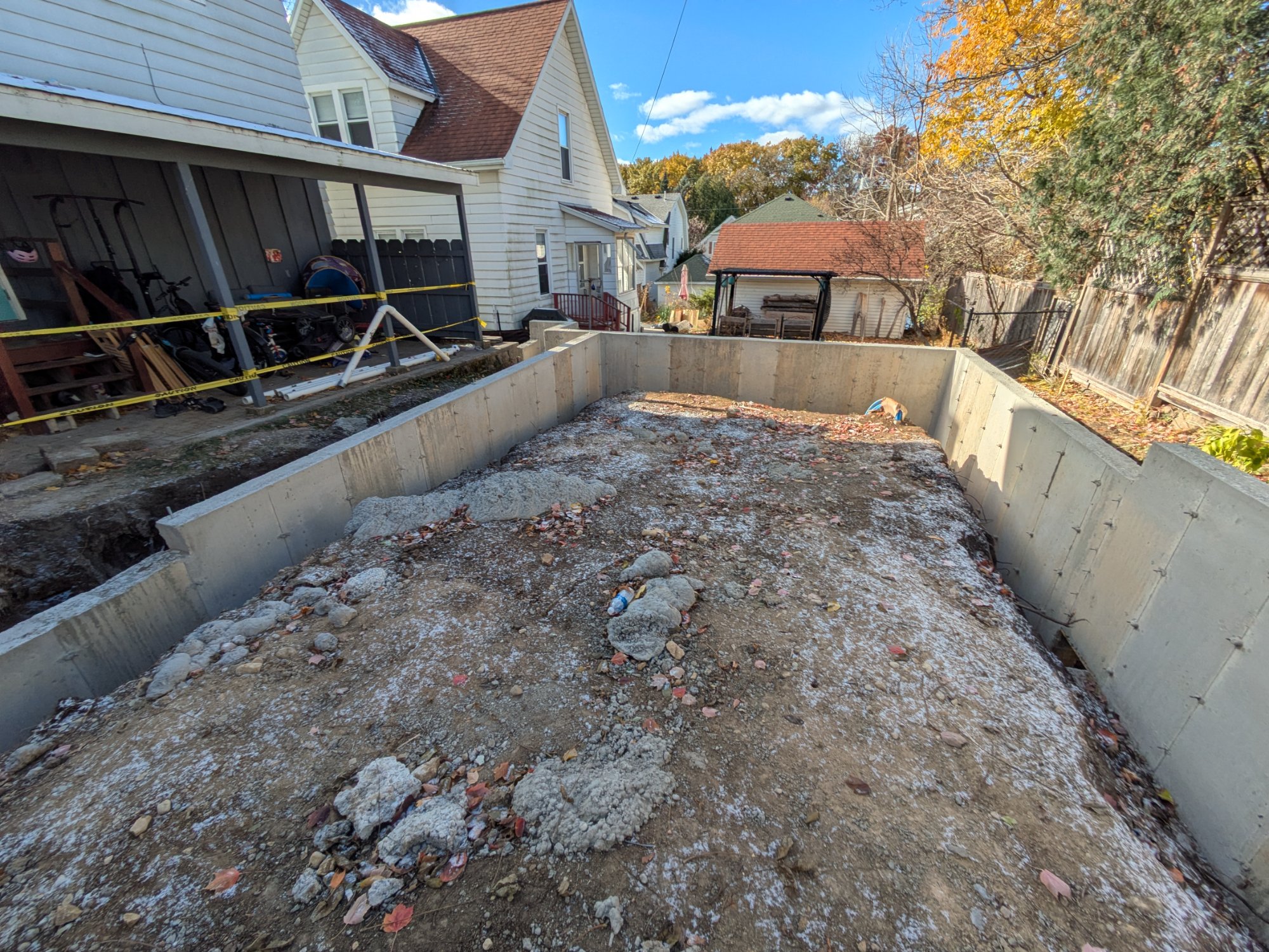

Foundation walls poured before slab — Henry Vilas ADU project Madison WI
Foundation walls poured — before slab
The Site

Constrained. Not impossible.

The backyard left little room for error:

  • 46 feet wide, 24 feet deep — every inch of allowable footprint mattered
  • A 5-foot grade change across the rear yard

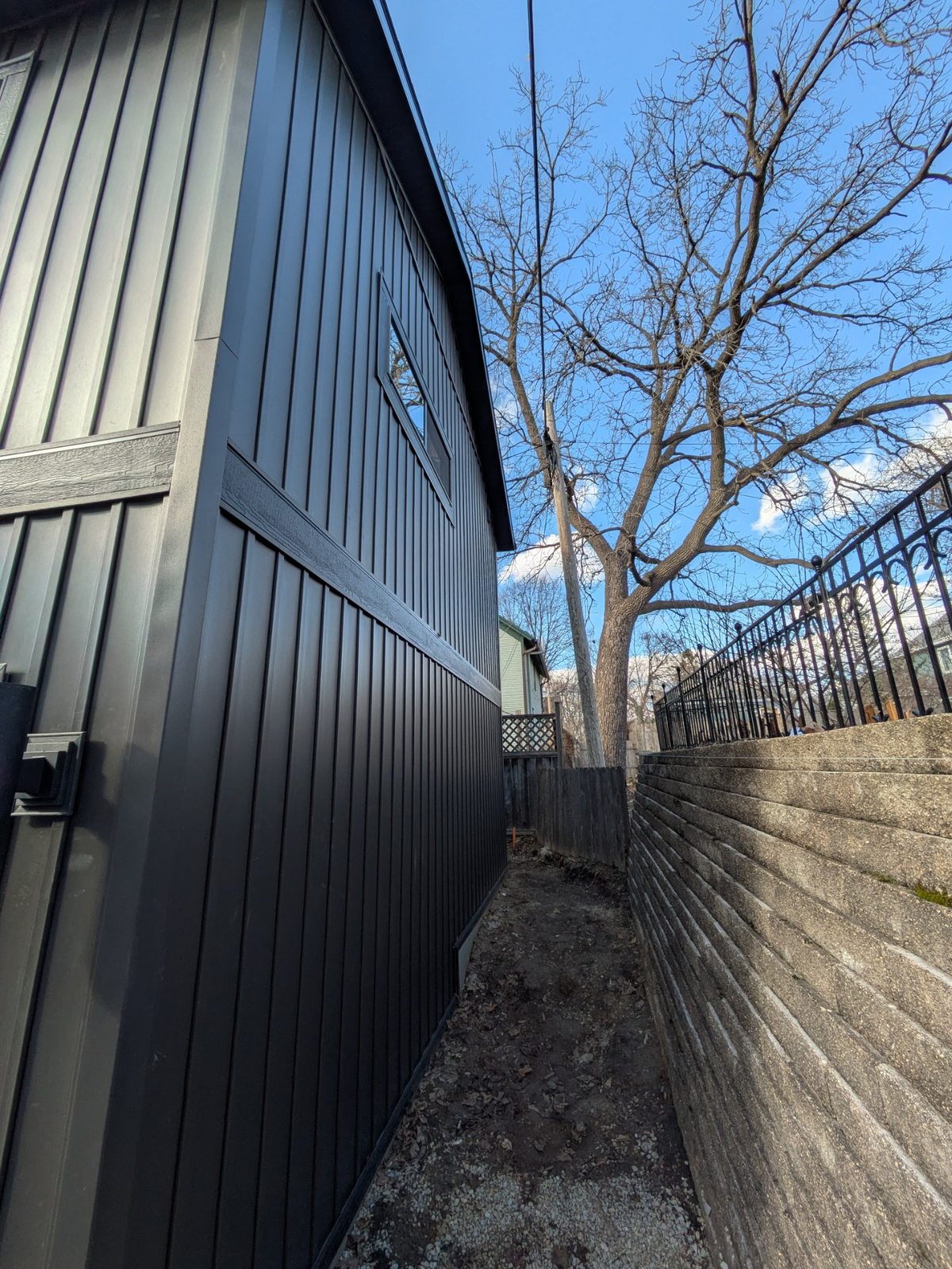

  • An 8-foot retaining wall running along one lot line
  • Narrow access to the build area — no easy staging or material delivery

The clients also had two driveways — one on each side of the house. The goal was to preserve both: one for the homeowners to access the garage below, one for future tenants to access the ADU above. Two households. Two independent entrances. One lot.

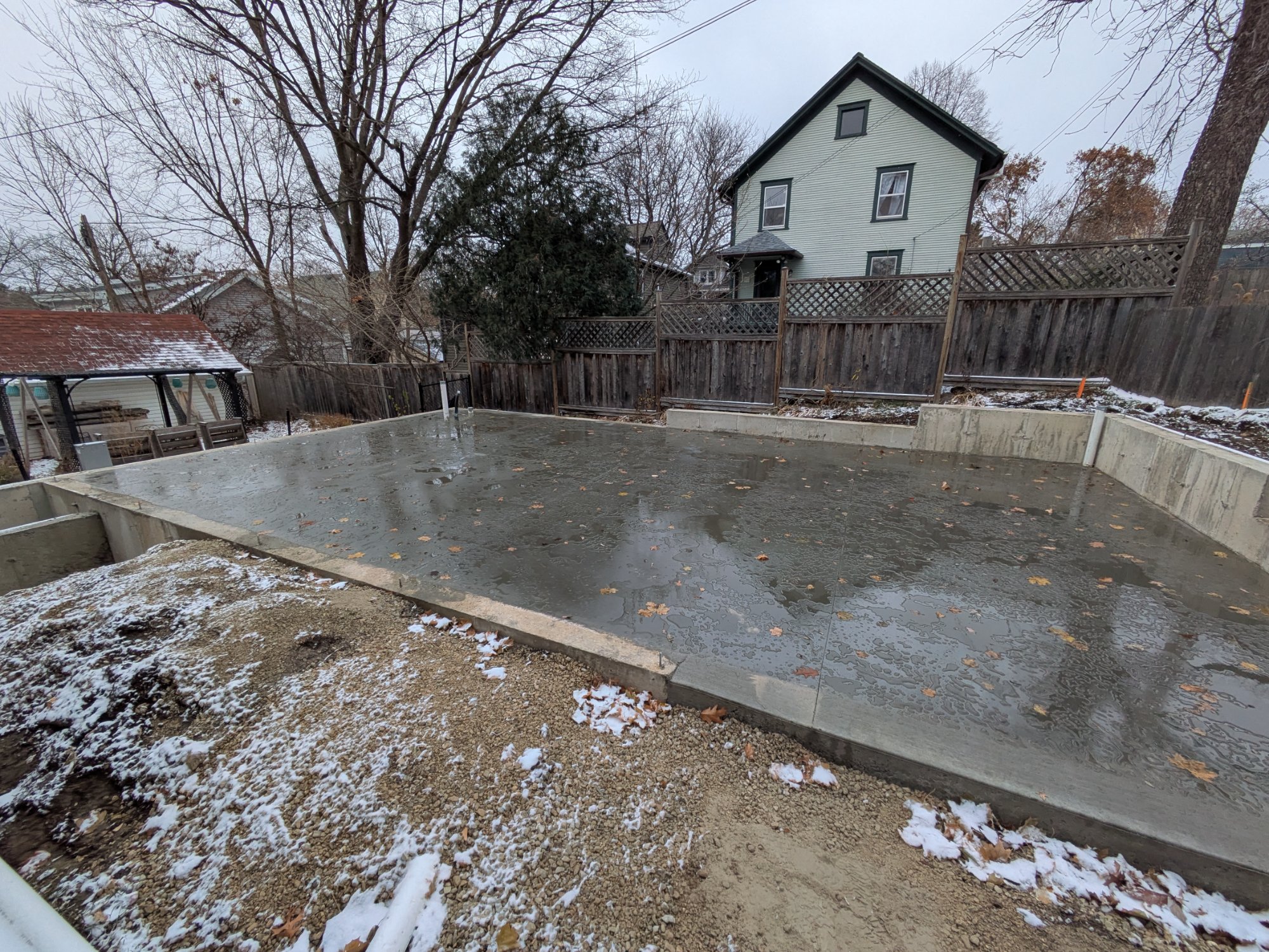

Fresh concrete slab pour for garage ADU foundation, Madison WI winter construction
Slab poured — the full 46×24′ footprint
The Build

Maximizing the footprint. Solving the grade.

We maximized the allowable footprint — fully utilizing the 46×24′ envelope — and designed a two-story structure: attached garage on the ground level, 700 square feet of living space above.

To solve the 5-foot grade change and create a safe, independent tenant entry, we added a second retaining wall along the opposite lot line and integrated a stair system directly into it. The result: a defined, private path from the driveway to the ADU’s front door. No shared entry. No awkward access. No afterthought.

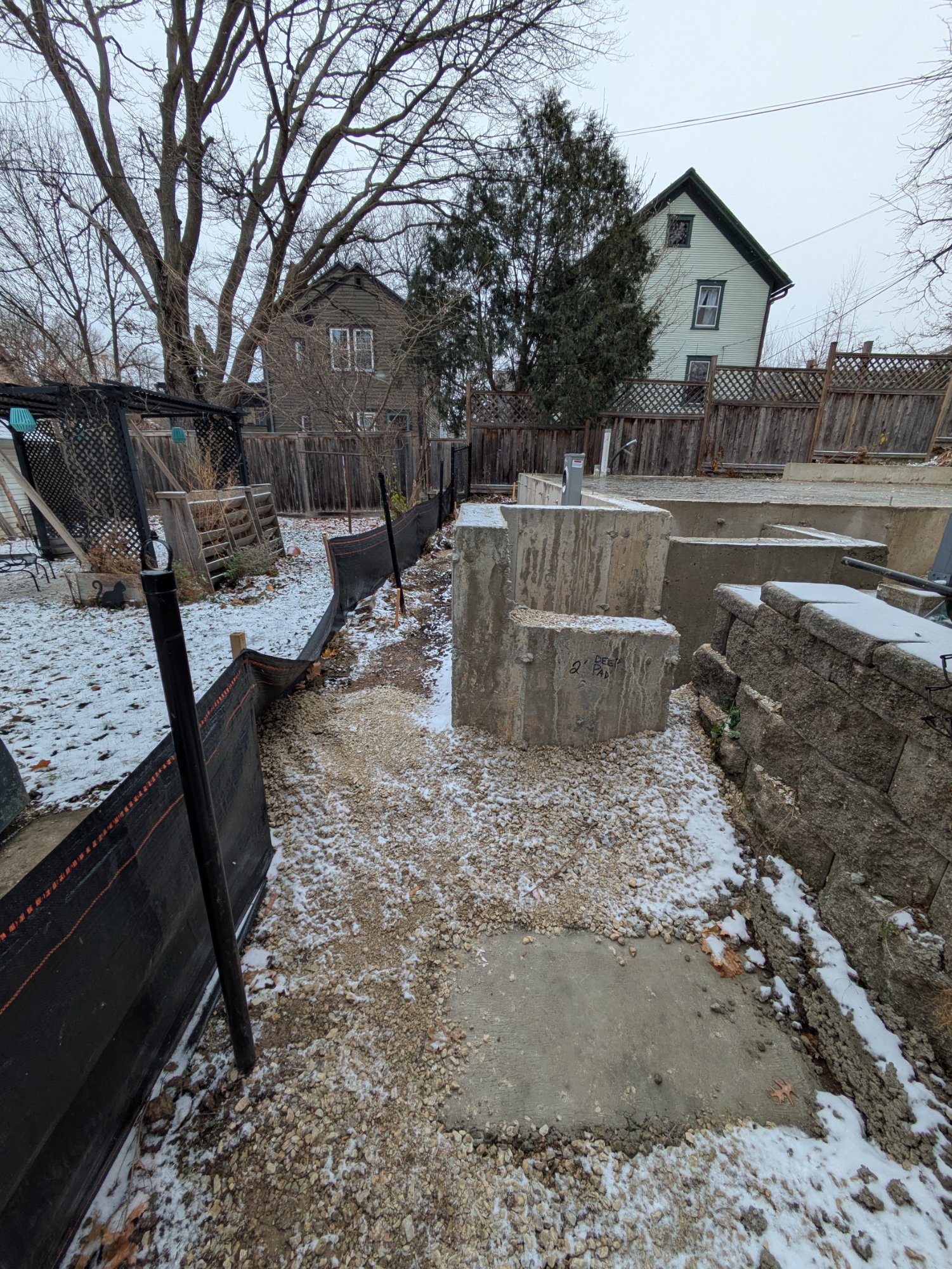

Lumber and materials staged on slab — Henry Vilas ADU framing prep, Madison WI
Lumber staged and ready — framing begins

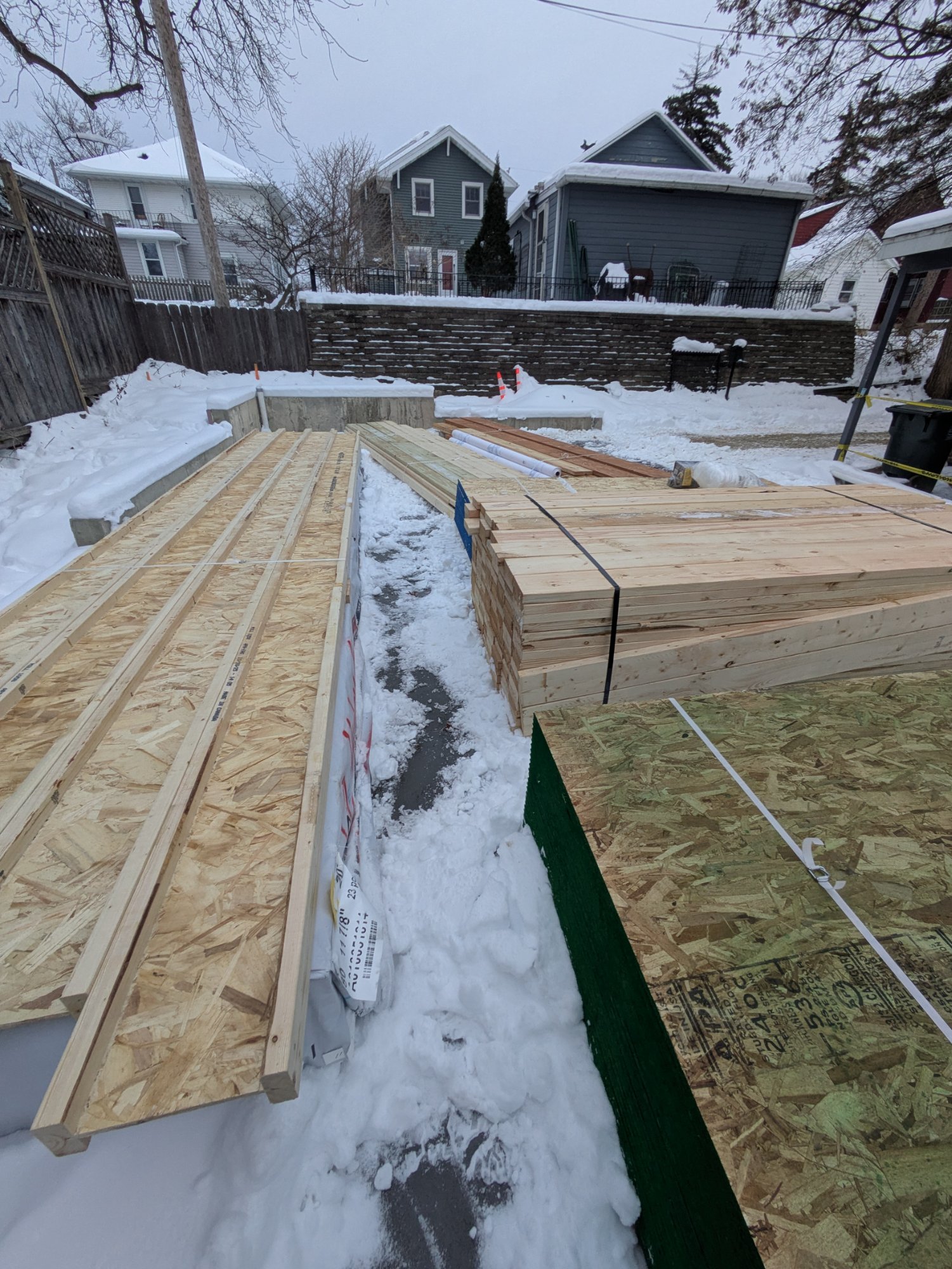

Exterior wood framing in winter — two-story garage ADU, Madison Wisconsin
Exterior framing — structure taking shape

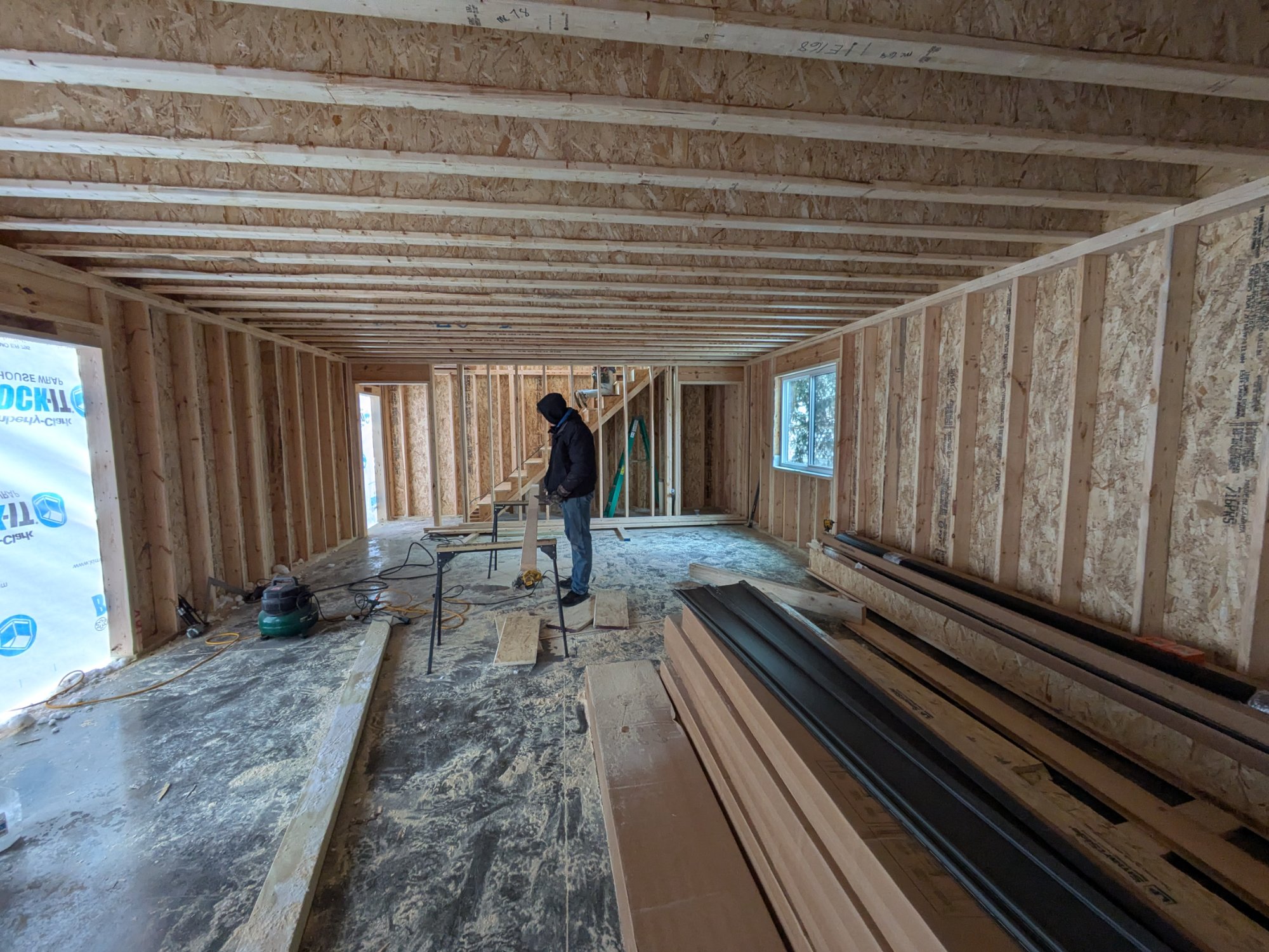

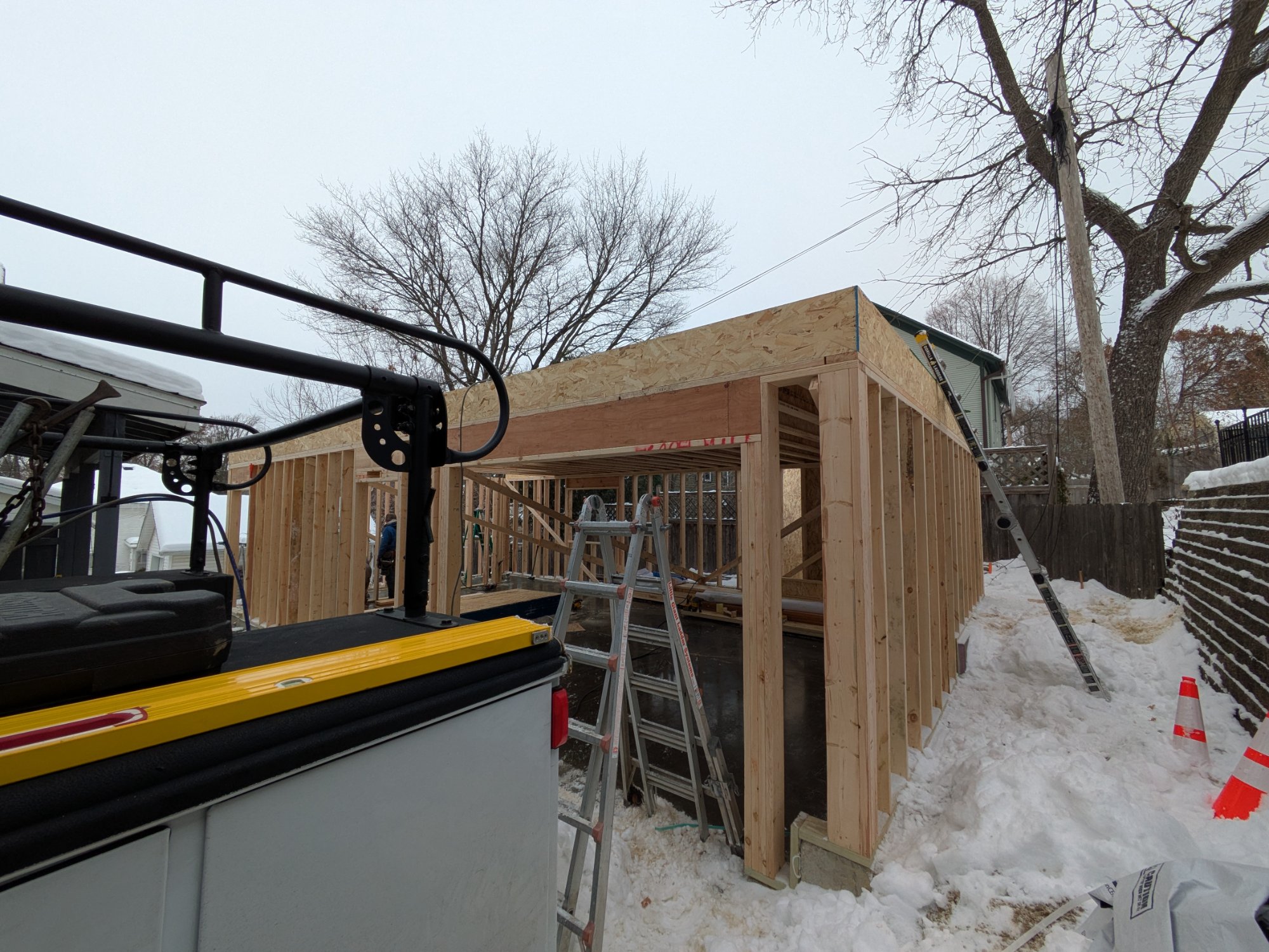

Interior wood framing of 700 sq ft ADU above garage — Madison WI construction
Interior framing — ADU level above the garage
How We Run the Job

Utility delays don’t stop a job. They redirect it.

Utility coordination introduced schedule pressure that was entirely outside our control. The local water utility needed to relocate a fire hydrant. The electric company had a service scheduling backlog of over two months before they could establish electrical service to the building.

We didn’t wait.

Every task we could advance — we advanced. Framing, insulation, interior work, systems rough-in — work continued wherever the schedule allowed. When utilities were finally coordinated and connected, we weren’t starting from where we left off. We were finishing.

Momentum isn’t something we protect only when conditions are favorable. It’s how we run the job.

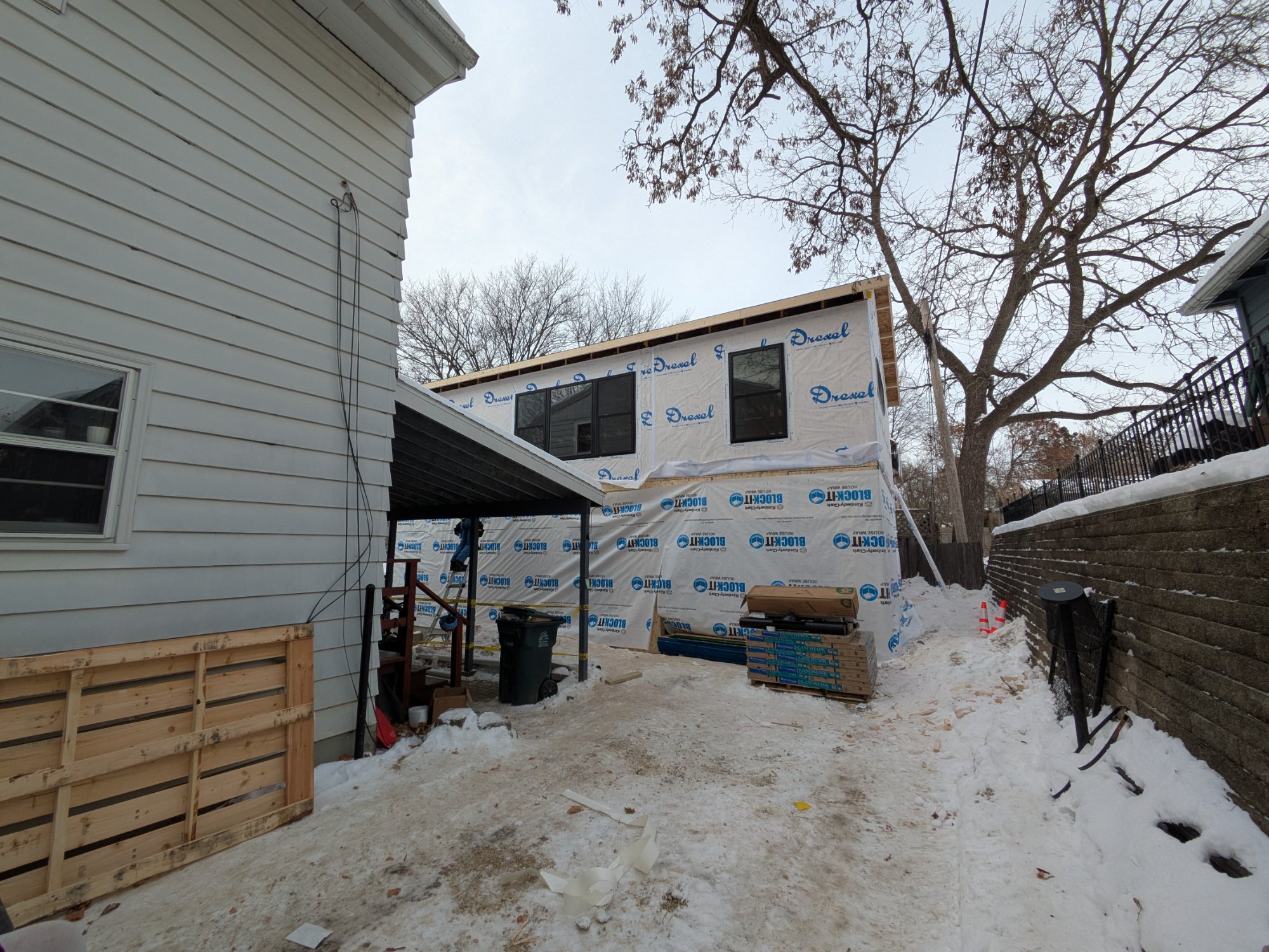

Two-story garage ADU building wrapped with housewrap — exterior view, Madison WI
Building wrapped — windows set, enclosed
Integrated stair access along retaining wall for private tenant entry — Henry Vilas ADU, Madison WI
Tenant stair integrated into second retaining wall

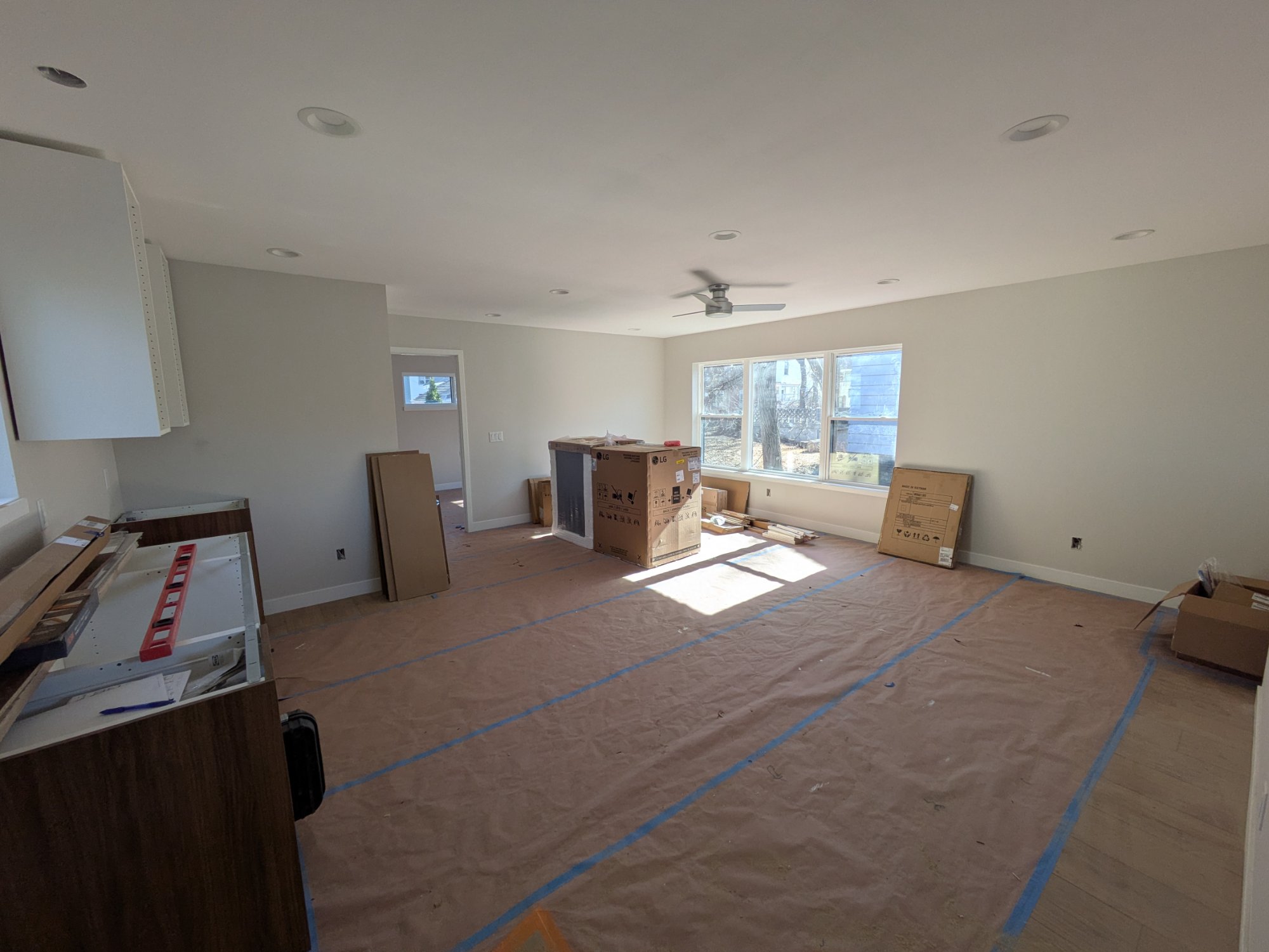

ADU interior at finishing stage with appliances being installed — Madison WI garage ADU
Finishing stage — appliances in, floors protected
The Finished Product

700 square feet. Fully independent. Ready in five months.

The ADU level delivers a complete, stand-alone living unit: open-plan kitchen and living area, a bedroom with walk-in closet, full bathroom, and a staircase that opens with natural light. The design makes the most of every square foot without feeling compressed.

Mini-split HVAC handles both heating and cooling efficiently — the right call for Wisconsin winters and a unit that needs to be cost-effective for tenants year-round.

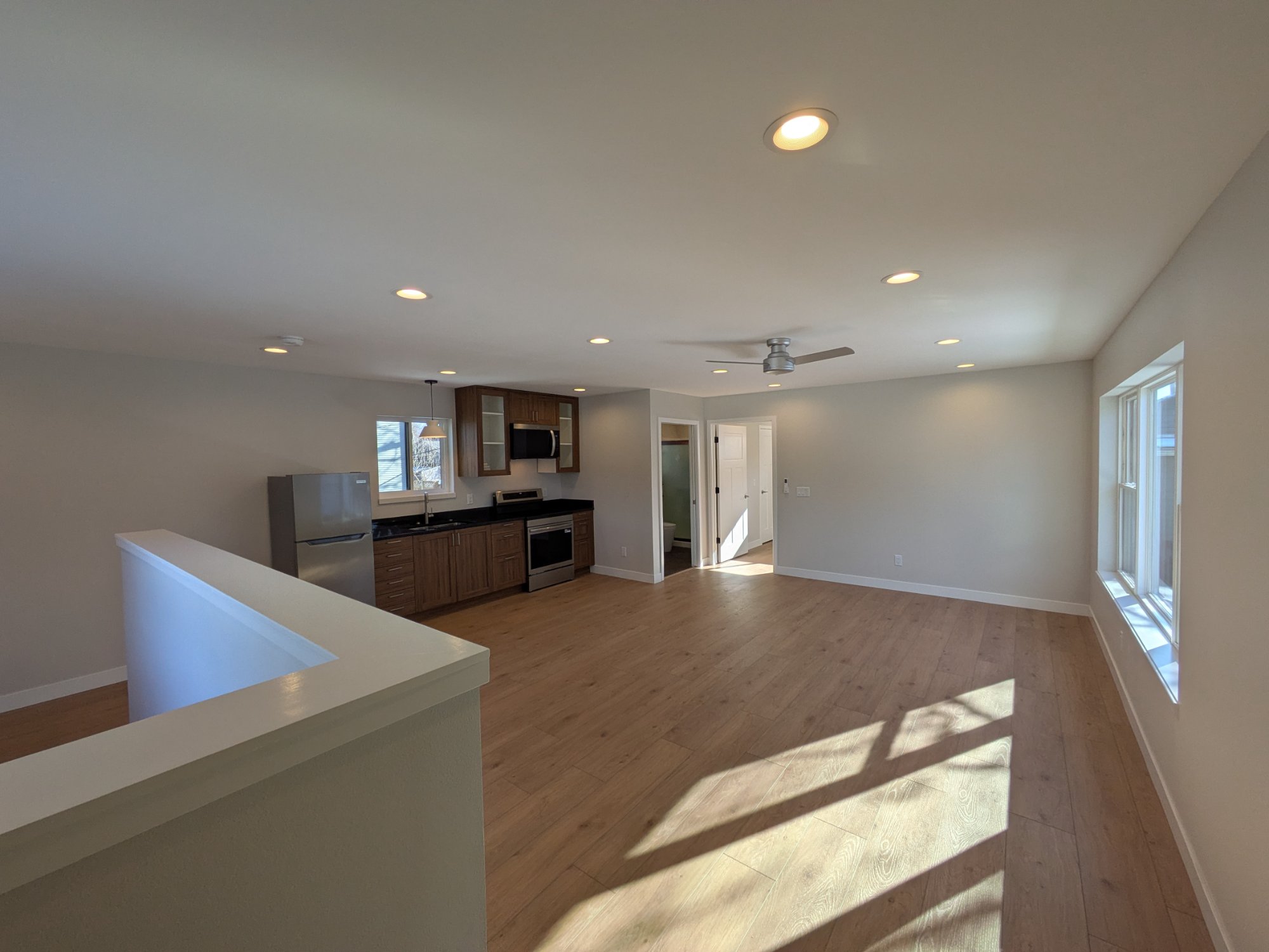

Finished open plan living and kitchen area of ADU above garage — Madison Wisconsin
Living area — open plan looking toward kitchen

Finished ADU kitchen with stainless appliances and dark countertops — Henry Vilas project Madison WI
Kitchen — full appliances, dark granite counters

Finished ADU staircase with large picture window — light-filled interior, Madison WI
Staircase — picture window floods the entry with light

Finished ADU bathroom with walk-in shower, vanity and window — Madison WI
Full bathroom with walk-in shower

Finished ADU bedroom with ceiling fan, mini-split HVAC and closet — Madison WI
Bedroom — mini-split, ceiling fan, two closets

Walk-in closet with skylight in finished ADU — Henry Vilas project Madison Wisconsin
Walk-in closet with skylight

Close-up of finished wood stair treads with white risers — ADU interior detail
Stair treads — wood and white, clean and warm
Upper landing with large window and open stair rail — finished ADU interior Madison WI
Upper landing — open rail, views to the street
Full Walkthrough

Video tour of the finished ADU

A walkthrough of the completed unit — from the tenant entry at the retaining wall stair through the full interior.

The Outcome

On budget. Certificate of occupancy in five months.

The project came in on budget. Construction started and reached certificate of occupancy within five months — utility delays and all.

Within the first week of receiving that certificate, the clients’ family was already in the space. Not setting it up. Not preparing. Living in it.

That’s the outcome this family had planned toward — more proximity, more flexibility, a property that works harder for them. They didn’t just get a building. They got exactly what they asked for, delivered the way it was promised, on the schedule and budget they planned around.

5mo Start to occupancy
On Budget — no overruns
700 Sq ft delivered
1wk Time to move-in after CO

Exploring an ADU or tiny home in Madison, WI or Dane County?
ADUs are all we do. Schedule a consultation and get real numbers — within a day.
